Sequence-dependent setup times¶
If you’re using this notebook in Google Colab, be sure to install PyJobShop first by executing
pip install pyjobshopin a cell.
This notebook demonstrates how to model sequence-dependent setup times in PyJobShop.
[1]:
from pyjobshop import Model
from pyjobshop.plot import plot_machine_gantt
Machines may require different configuration settings for processing different types of tasks. This results in sequence-dependent setup times, which is the time that is required to reconfigure machines between processing two tasks. Let’s showcase a small example here.
[2]:
model = Model()
tasks = [model.add_task() for _ in range(6)]
machines = [model.add_machine() for _ in range(2)]
for task in tasks:
# The first machine is faster than the second machine.
model.add_mode(task, machines[0], duration=1)
model.add_mode(task, machines[1], duration=3)
for task1 in tasks:
for task2 in tasks:
# But the first machine has much longer setup times.
model.add_setup_time(machines[0], task1, task2, duration=5)
model.add_setup_time(machines[1], task1, task2, duration=1)
[3]:
result = model.solve(display=False)
print(result)
Solution results
================
objective: 13.00
lower bound: 13.00
status: Optimal
runtime: 0.10 seconds
[4]:
data = model.data()

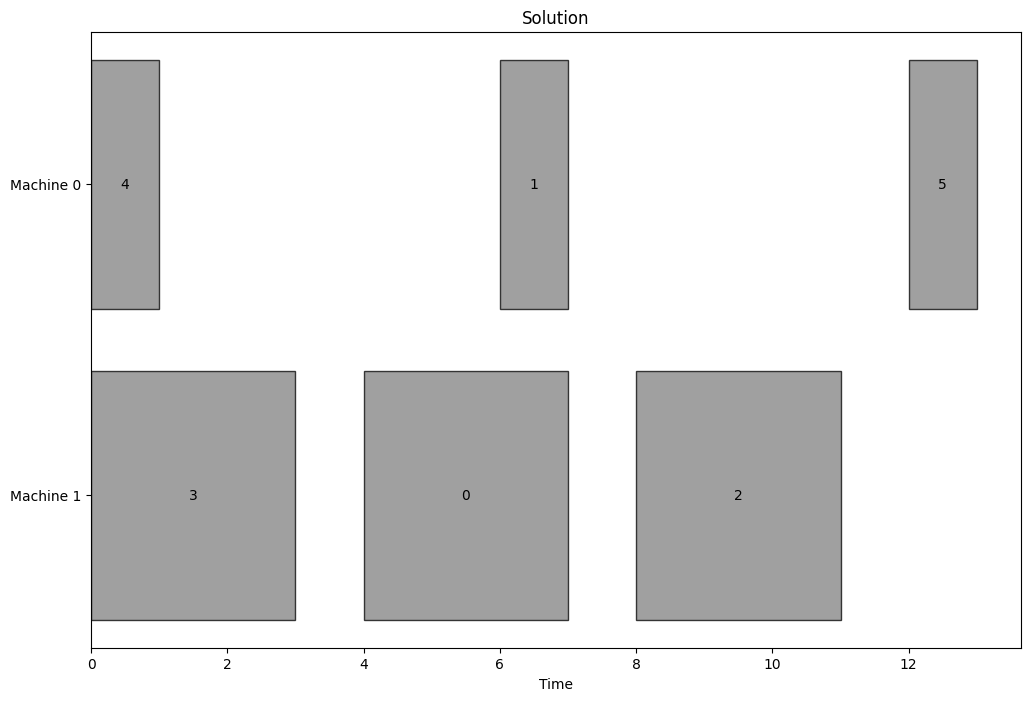

plot_machine_gantt(result.best, data, plot_labels=True)
Some notes:
Instances with sequence-dependent setup times are generally hard to solve, and it’s even harder to solve to optimality. Consider using a time limit when solving such instances.
Unlike CP Optimizer, OR-Tools does not have specialized constraints to deal with sequence-dependent setup times. This makes the implementation of OR-Tools substantially slower.
